Solution Overview
As you know SAP KANBAN solution have provided external procurement function which can issue summarized JIT Call document to suppliers for fulfillment. it is definitely containing delivery date and time in the header information on summarized JIT Call documents, and those can be calculated by SAP standard JIT calculation profile configuration also. but during the solution delivery, you will be facing the “CYCLE” issues which was broadly and deeply operated on Japan automotive OEM and their suppliers who running KANBAN in factory.
Client Requirements analysis
In Japan one of biggest automotive OEM and their suppliers running KANBAN for external procurement depends on “CYCLE” definition, they have specified delivery time table which already agreed with each suppliers and carries, for example, if the “CYCLE” defined as “1-4-2” for one of KANBAN material and it is belong to specified route which defined delivery time as 9:00, 12:00, 15:00, 18:00 already, that means if you release external procurement KANBAN before 9:00 to supplier for fulfillment, then this KANBAN will come back on same day at 15:00 from suppliers. stands on SAP documents flow perspective, when you release external procurement KANBAN which using summarized JIT Call strategy before 9:00, then you have to specify the delivery date and time on your released summarized JIT call document depends on “CYCLE” and time table information. because SAP does not have “CYCLE” concept in the KANBAN solution, accordingly these requirements became as a gap we have to accomplish during the delivery.
Delivered Solution

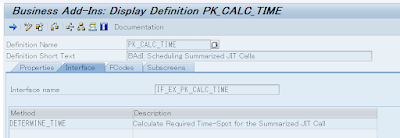

1. ”CYCLE” enhancement in control cycle master
No comments:
Post a Comment
